The Fourth Bridge over the Panama Canal has reached 37 percent completion after one year and ten months of work. The Ministry of Public Works Panama confirmed the milestone on June 3, 2026. This massive infrastructure project aims to connect the western sector with Panama City, an area plagued by chronic traffic congestion for years.
📑 Table of Contents

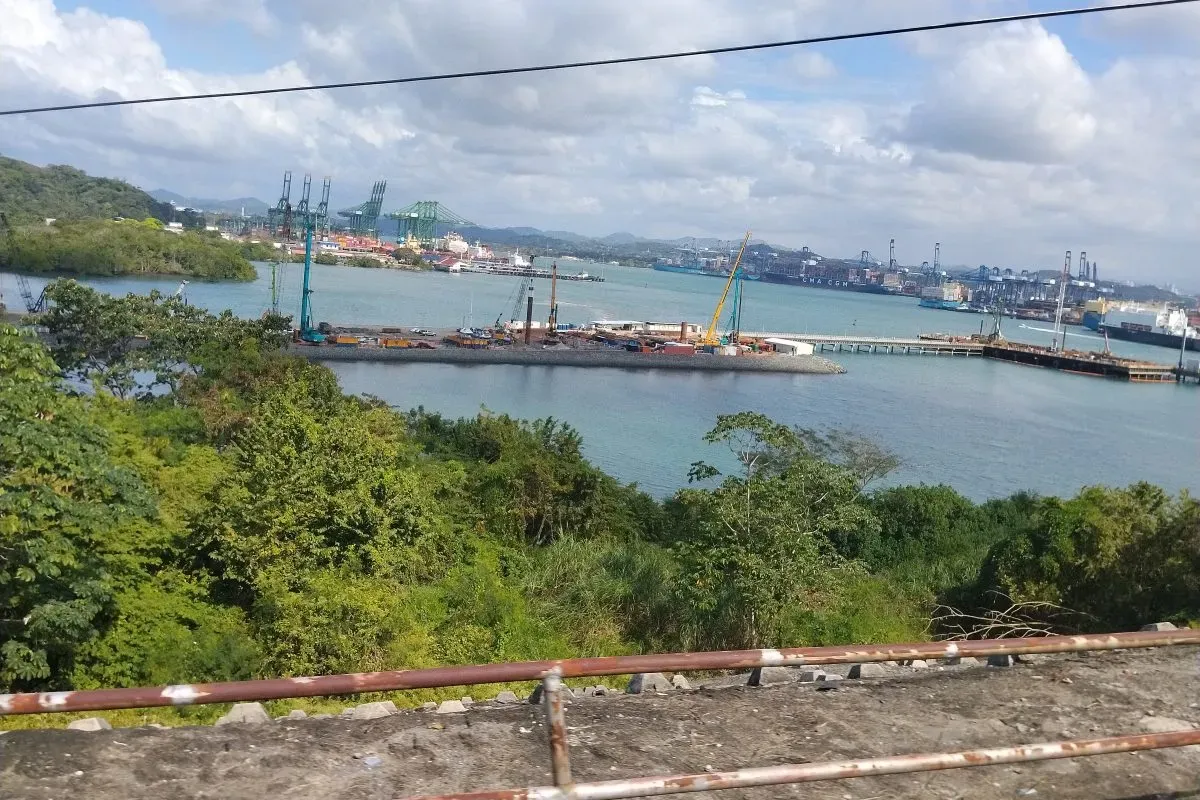

Public Works Minister José Luis Andrade led a site inspection and detailed the current work. The project is now in its foundation and structural phase. Crews are constructing piles, relocating utilities, installing gravel columns, and building initial structures on the east side of the project. At Cerro Sosa, visible components include main piers, H-shaped columns, and ongoing excavations that demonstrate the tangible progress achieved in recent months.
Pile Phase Set for July Completion
Official schedules show the pile phase must conclude by the end of July. Once finished, the focus will shift to building viaducts and other primary structures that form the bridge and its access roads. Minister Andrade confirmed the December 2028 delivery date during the inspection. The goal is to maintain the current execution pace and meet the planned calendar for one of the country’s most ambitious infrastructure projects.
The project has generated significant infrastructure project employment. Official figures show the workforce grew from approximately 300 workers in early stages to more than 2,000 direct jobs today. This represents nearly 6,000 total positions when combining direct and indirect employment linked to construction and related activities.
Authorities project these numbers will continue rising in coming months. The project could reach 3,000 direct jobs and maintain around 6,000 indirect positions as new construction phases advance, particularly those involving access roads, foundation heads, and other main structures.
Minister Andrade recalled that at the start of the current administration, the project showed progress near 1 percent or less. The operational structure for monitoring was limited, with only two people within the Ministry assigned to oversee the mega-project.

August 2024 Marked a Turning Point
Andrade stated that August 24, 2024 represented a critical inflection point for the project. That day marked the start of the first permanent excavation. In his view, this stage effectively propelled the project forward after several previous attempts that never materialized. [Translated from Spanish]
Since that date, work has advanced continuously. To strengthen supervision and institutional coordination, the Ministry created a specialized high-level office staffed by engineers with experience in large infrastructure projects. This unit coordinates among different institutions, including the Panama Canal Authority, port concessionaires, and other entities involved in the project’s development. It also addresses technical or administrative issues that could affect the execution schedule.
The Fourth Bridge’s future operation includes a toll system managed by the National Highway Company. The toll amount has not been defined yet, but authorities maintain this mechanism will be necessary to contribute to the infrastructure’s maintenance and sustainability once operational. The road scheme will also include connections with Roberto F. Chiari Road and the North Corridor.
As an alternative, drivers can continue using the Bridge of the Americas. That structure will remain operational as a complementary route. Andrade announced it will be rehabilitated to serve a more local function. The government maintains that despite challenges during initial stages, the Fourth Bridge has entered a sustained execution phase. It is positioned as a key project to improve mobility and connectivity across the metropolitan area.
